Belgian rail operator SNCB has opened the SNCB maintenance hall Ostend at its traction workshop, supported by a EUR 47 million investment within a wider effort to modernize rolling stock maintenance infrastructure, as outlined in an SNCB press release.

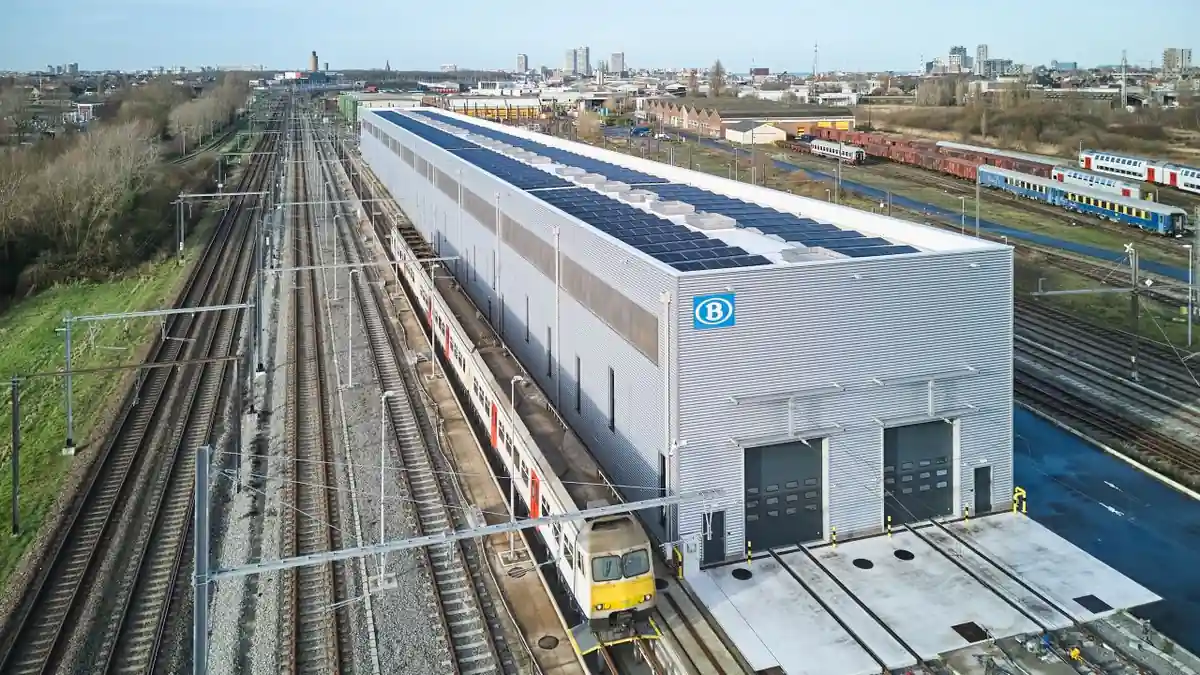

SNCB maintenance hall Ostend: TIM “pit stop” model
SNCB maintenance hall Ostend: TIM “pit stop” model

This is reported by the railway transport news portal Railway Supply.

It is the fifth hall of this kind commissioned by SNCB in recent years, following Arlon, Hasselt, Kinkempois and Melle. The operator says the goal is to lift train availability and reliability, helping improve punctuality across services.

Don’t miss…AmeriStarRail “AmeriStarliner” long-distance fleet proposal

SNCB maintenance hall Ostend: layout built for faster work

The hall was built for quicker servicing. It stretches 200 metres in length, is 18 metres wide and 13 metres high, and it includes two through lines that can be entered from either end. That arrangement lets teams work on long trainsets without the time penalty of uncoupling multiple units, while still leaving room to accommodate up to four trains inside at once.

Beyond the building itself, the project adds a 370-metre outdoor inspection channel, set up to support several work stations beneath trains. The channel also includes a mobile platform for pantograph interventions, making roof access easier and helping reduce downtime. SNCB has also invested in cleaning platforms, an industrial signalling system, and new manoeuvring equipment capable of moving trains inside the workshop.

Work on the project began in 2020, and the new facility is expected to become operational by the end of 2025.

Timetable Integrated Maintenance (TIM) and the “pit stop” approach

With the hall now in operation, SNCB says the Ostend traction workshop can work to the Timetable Integrated Maintenance (TIM) principle — a method it compares to a motor-sport “pit stop”. The idea is to bring trains in more often, but for shorter visits, scheduling tasks during periods of lower traffic.

On average, SNCB indicates a train is brought in for maintenance every two weeks, with work lasting around four hours so it can return to service quickly. To keep availability as high as possible for the morning rush hour, technical teams also carry out work overnight.

Sustainability upgrades and the Ostend traction workshop’s role

Sustainability and ergonomics were built into the design. More than 900 photovoltaic panels were installed on the roof, providing an installed capacity of about 400 kW, with electricity used directly to partially cover the workshop’s consumption. Rainwater is also collected and reused. For staff, upgrades include floors lowered below track level, deeper working channels, mobile platforms, and modern lifting systems intended to improve safety and efficiency.

The Ostend traction workshop remains a key hub for West Flanders. It has around 250 employees and handles monthly maintenance, repairs and cleaning for nearly 400 multiple units and locomotives, supporting rail operations in the region and beyond; SNCB also describes the site’s work on its official Ostend traction workshop page. As part of its 2023–2032 investment plan, SNCB is allocating EUR 1.4 billion to workshops and maintenance infrastructure, equivalent to about 15% of the company’s total investment budget.
