Mumbai-Ahmedabad Corridor: Sabarmati River Bridge Hits Major Superstructure Milestone
28.04.2026
Sabarmati River bridge construction is moving forward in Ahmedabad as part of the Mumbai–Ahmedabad Bullet Train corridor. This is reported by the railway transport news portal Railway Supply.

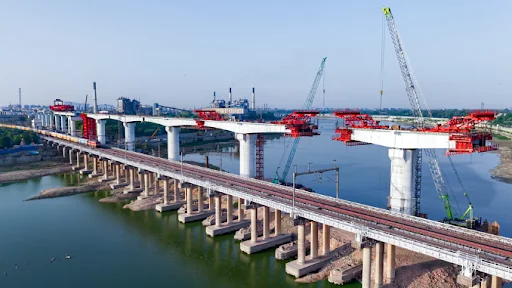

The bridge is designed as a 480-metre-long structure. It rises 36 metres above the river and runs alongside the existing railway corridor. With all piers and foundation works completed, the project has entered the superstructure construction stage.
Sabarmati River bridge construction and corridor role
The bridge over the Sabarmati River in Gujarat is taking shape as part of the Mumbai–Ahmedabad Bullet Train corridor, according to the Press Information Bureau. Its 36-metre height is roughly comparable to a 12-storey building.
Also, the structure sits between Sabarmati and Ahmedabad Bullet Train stations. It runs parallel to the existing Ahmedabad–Delhi railway line. Its position, about 1 km from Sabarmati station and around 4 km from Ahmedabad station, makes it a vital link within this corridor section.
Don’t miss…ARTC Launches 5-Day “Super Possession” Across Sydney-Melbourne Corridor for $1B Upgrade
Engineering design and construction method
The bridge design includes eight circular piers. Each pier measures between 6 and 6.5 metres in diameter. Their placement has been planned to limit disruption to the river’s natural flow.
The pier layout includes:
- Four piers in the riverbed
- Two piers on the riverbanks
- Two piers outside the river zone
The piers range from 31 to 34 metres in height. They provide structural stability while taking hydrological conditions into account.
The bridge consists of:
- Five spans measuring 76 metres each
- Two spans measuring 50 metres each
Each span is being built with 23 cast-in-situ segments. This supports both precision and durability in the structure.
A central construction feature is the Balanced Cantilever Method, which Rail Analysis India describes as a specialized technique for long-span bridges over water. This method removes the need for scaffolding beneath the bridge. It allows work to proceed without obstructing the river.
In addition, segments are added symmetrically on both sides of each pier. They are then joined through post-tensioning. This supports:
- Structural balance and stability
- Efficient construction over deep water
- Reduced environmental impact
Current progress and environmental measures
The project has reached a significant stage. All foundation and substructure works have been completed.
Current progress includes:
- Completion of three 76-metre spans
- Ongoing pier head construction
- Steady progress on segment casting activities
At the same time, this milestone reflects consistent execution and adherence to the project timeline.
Construction planning has also focused on maintaining the natural flow of the Sabarmati River. Engineers have used hume pipe culverts within temporary embankments. They have also kept a natural discharge channel in place.
These measures are intended to keep water movement uninterrupted. They are also intended to preserve the river ecosystem and prevent construction-related disruption.
Key highlights include:
- 36-metre bridge height, approximately equal to 12 storeys
- Total bridge length of 480 metres
- Eight strategically positioned piers
- Balanced Cantilever Method used for construction
- Foundation and substructure works completed
- Focus on environmental sustainability
Still, the article’s conclusion remains centred on the bridge’s role in the Mumbai–Ahmedabad Bullet Train corridor. The Sabarmati River bridge reflects India’s engineering capabilities and infrastructure ambition within that corridor. As construction continues, the structure strengthens this section while reflecting sustainable and innovative bridge-building practices.
