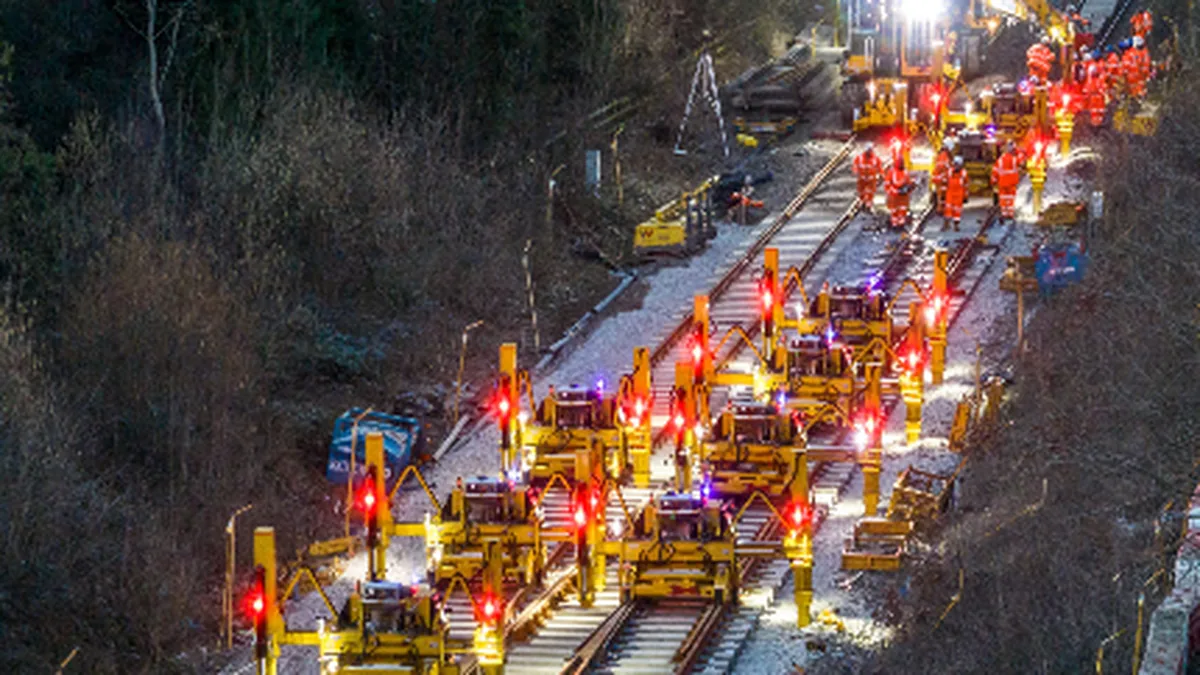

Huddersfield and Leeds engineering works are scheduled for May and June. As reported by Railway News, TRU teams will carry out engineering work on the route. These works form part of the Transpennine Route Upgrade.

Huddersfield and Leeds Engineering Works Planned by TRU
Photo: Network Rail

Huddersfield and Leeds engineering works in May

Between Saturday 2 May and Monday 25 May, 56 engineering trains will be used. They will renew 6.2km of track. In addition, they will lay 21,000 tonnes of ballast. Also, they will install 51 foundation bases along the 70-mile route.

Don’t miss…Belgrade Metro Line 1 moves ahead under Alstom deal

During this period, Brighthouse station will be used as a rail and bus interchange. Meanwhile, customers will remain on trains by using diversionary routes. TRU has invested 100 million GBP into those routes. At the same time, other rail services will keep running. They will operate as close as possible to the closure areas. In addition, replacement buses will be available to keep customers moving and reduce disruption.

Batley station reopening and Dewsbury platform extensions

From Saturday 30 May to Saturday 27 June, a final phase will be delivered. As Network Rail notes, this phase will cover Batley and Dewsbury. Once completed, this work will see Batley station reopen. The final commissioning of new lifts will also take place. This will provide customers with step-free access. At the same time, the station will receive a number of improved customer facilities. Also, its platforms will be extended to 150 metres.

Separately, Dewsbury will also reopen. Its platforms will be extended to 200 metres. This will allow longer, higher-capacity trains to serve the station in the future.

Meanwhile, 66 engineering trains will be used in this phase. They will deliver more than 5km of track renewals. In addition, 27,000 tonnes of ballast will be laid. Also, around 800m of drainage will be installed. At the same time, 67 OLE masts will be installed.

Huddersfield station transformation and travel arrangements

During the same two-month period, the TRU team will also work on weekends. This work will take place at Huddersfield station. For example, crews will carry out platform remodelling and subway excavations. In addition, they will build a new staircase and footbridge. Also, work will continue to extend the canopy of the station’s Euston style roof. These upgrades form a major part of the Huddersfield station transformation. They will be completed in early 2027.

During the week, customers will be kept moving. They will travel between Huddersfield and Leeds via the Wakefield diversionary route. Meanwhile, trains will run as close as possible to the closure area at weekends. In addition, replacement buses will run between Huddersfield and Leeds.

Sophie Leishman, TRU sponsor, said:

“Significant progress has been made between Huddersfield and Leeds in recent months, and this next series of upgrades will allow us to take another step forward in what is a key stretch of the route and an important enabler for wider TRU plans across the North.

Our teams will be working around the clock during these two months. I’d like to thank them as well our local communities as we deliver these huge improvements to the railway.”
