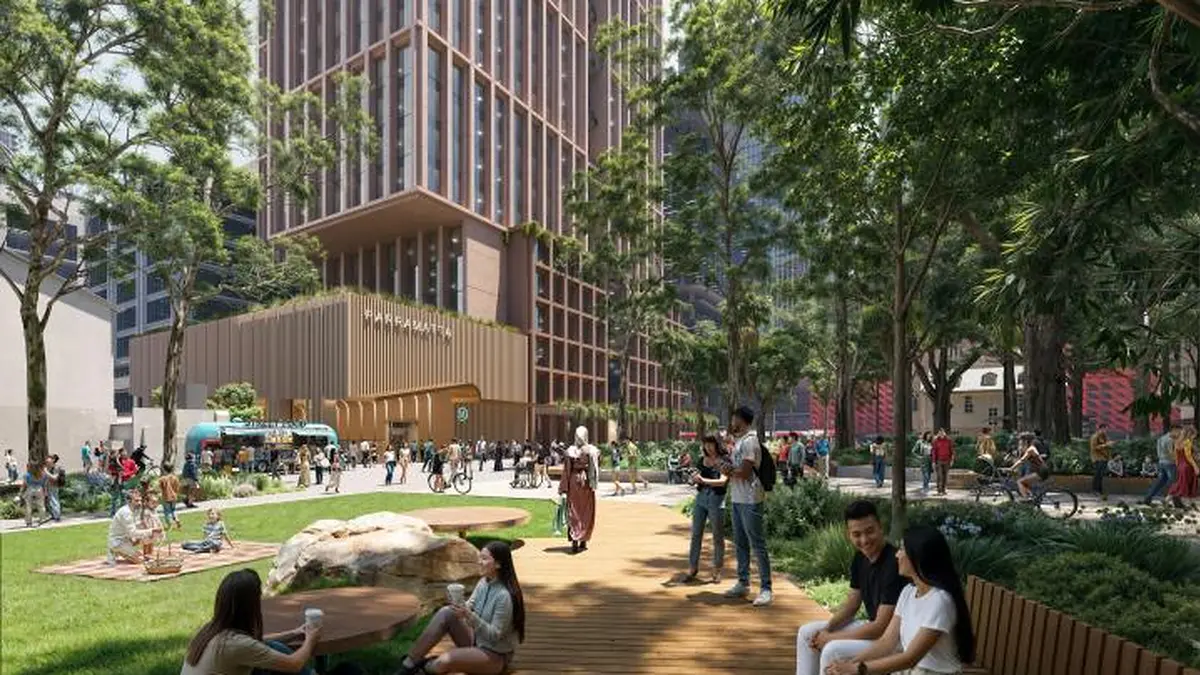

Parramatta Integrated Station Development marks first joint project
Australia: The Parramatta Integrated Station Development marks the first time Gamuda Engineering Australia, Gamuda Land Australia and MTR Corporation Australia have joined forces on one integrated transport-oriented development.

Three partners building together for the first time
The three companies form the Riverside Link Consortium, which Sydney Metro has appointed to deliver the station at Parramatta and the buildings above and adjacent to it. In the announcement MTR Corporation issued on 8 September 2026, Ewan Yee, chief executive of Gamuda Engineering Australia, called the award more than another station contract and “the first time all three partners have joined forces” on one integrated transport-oriented development for Parramatta. He credited the record built on the Western Tunnelling Package for the client’s confidence.
MTR frames its own contribution as experience in rail-connected communities. David Tang, managing director for property and international business, said the project lets the company apply its work integrating transport infrastructure with residential, commercial and community development. The contract was signed with Sydney Metro represented by acting chief executive Hugh Lawson and Metro West delivery director Matt Deeks.
What the award covers
Sydney Metro made the award on 3 September 2026. The announcement Gamuda Berhad filed with Bursa Malaysia names the design and construction of the future Parramatta metro station and its associated station infrastructure as the principal component, valued at AUD880 million inclusive of incentives. Gamuda Engineering and MTR Australia hold that work on an 80:20 participation basis, with commencement on 4 September 2026 and completion targeted for 2032.
The award also carries development rights for the buildings above and beside the station. Gamuda (Australia) and MTR Australia participate equally in that component, and the current precinct concept approval allows for four integrated station developments providing commercial, retail and residential uses. Both companies state that these will be delivered in phases following the opening of Sydney Metro West. Gamuda adds that the component is ancillary to the station works award and subject to planning approvals and to final contractual and funding arrangements, with no value disclosed.
The New South Wales Government release describes the same $880 million as covering the station, the precinct and the developments above and adjacent to it. It sets out four buildings: a 43-storey build-to-rent tower with 470 apartments, a 29-storey commercial tower, a 24-storey building with 500 student accommodation units and an eight-storey hotel. Residential dwellings would rise from 111 to 970 against the concept plan approved in March 2025, with uses and design still subject to further development, planning approvals and public exhibition.
| Item | Station works | Development rights component |
|---|---|---|
| Disclosed value | AUD880 million, inclusive of incentives | None disclosed |
| Participation | Gamuda Engineering 80%, MTR Australia 20% | Gamuda (Australia) and MTR Australia participate equally |
| Timing | Commencement 4 September 2026; completion targeted for 2032 | Delivered in phases following the opening of Sydney Metro West |
| Stated conditions | None stated in the announcement | Planning approvals and final contractual and funding arrangements |
| Status within the award | Principal component | Ancillary to the station works award |
Fields as published in the Gamuda Berhad announcement of 3 September 2026 to Bursa Malaysia. Where a cell reads that nothing is disclosed or stated, the announcement gives no figure or condition for that item; it is not a value of zero.
Two start dates for the same site
The documents also give different starting points. These are different milestones: Gamuda dates the start of design and project activities to 4 September 2026, while the state release schedules station construction to begin in mid-2027. Both point to the 2032 opening of Metro West, with a target journey time of about 20 minutes between Parramatta and the Sydney central business district.
Sixth station on the Metro West alignment
Gamuda says the award builds on the Sydney Metro Western Tunnelling Package and the Stations Package West covering Westmead, North Strathfield, Burwood North, Five Dock and The Bays. Parramatta will be the sixth station the contractor delivers for Sydney Metro on the alignment.
| Package | Scope named by Gamuda |
|---|---|
| Western Tunnelling Package | Tunnelling on the Metro West alignment |
| Stations Package West | Five stations: Westmead, North Strathfield, Burwood North, Five Dock, The Bays |
| Parramatta Integrated Station Development | Parramatta metro station and associated station infrastructure |
The sixth station Gamuda Engineering delivers for Sydney Metro on this alignment is Parramatta, counting the five stations of the Stations Package West.
What each partner brings to the precinct
MTR has run Sydney Metro Northwest through its subsidiary Metro Trains Sydney since 2019 and supported the 2024 opening of the City line, now the M1 Northwest and Bankstown Line. It reports passenger satisfaction of 98% and service punctuality of 99.4% on that network. A joint venture between MTR and a CRRC subsidiary earlier won the Sydney Metro West operations and maintenance contract, which runs for 15 years from the start of service in 2032.
On the Gamuda side, Gamuda Land Australia was established in 2015 and built its residential portfolio in Melbourne, including 661 Chapel St. and The Canopy on Normanby. Gamuda Engineering Australia was launched in 2019 to drive the group’s infrastructure expansion. Beyond the Sydney Metro packages, its portfolio includes the Coffs Harbour Bypass and the Black Hill to Tomago package of the M1 Pacific Motorway extension to Raymond Terrace, both for Transport for NSW.
Gamuda lists planning approval as a project risk. The development scheme has to clear the City of Parramatta Council and state authorities, and the company says a complying scheme was adopted and the council engaged before the date of award as part of due diligence. It also says construction costs were benchmarked against independent estimates, with inflation and contingency buffers budgeted.
